Build on Your Lot in Prince William County, Virginia

From compact suburban neighborhoods to semi-rural acreage, plan a home around the realities of your property.

Resolve zoning, Resource Protection Areas, utilities, soils, access, and site work before the architecture is finalized.

Request a Lot Evaluation

A Diverse County

The right process depends on the parcel

Prince William County contains planned communities, suburban infill, rural-edge properties, and agricultural land. The exact district, subdivision history, utility system, environmental mapping, and road access can substantially change what fits and how it is approved.

Illustrative Zoning Standards

Typical setback screening

Corner lots, planned districts, recorded plans, building lines, accessory uses, and current ordinance provisions can change these figures.

Critical rule: Never rely on a neighboring house or outdated survey. Confirm zoning and have the actual setbacks shown on a current survey.

DistrictFrontSideRearTypical context
A-1 Agricultural35 ft15 ft25 ftLarger rural parcels
R-2 Suburban Residential35 ft10 ft25 ftAbout 2 dwellings per acre
R-4 Suburban Residential30 ft10 ft25 ftHigher-density single-family
SR, PMR & other districtsVariesVariesVariesConfirm district-specific standards

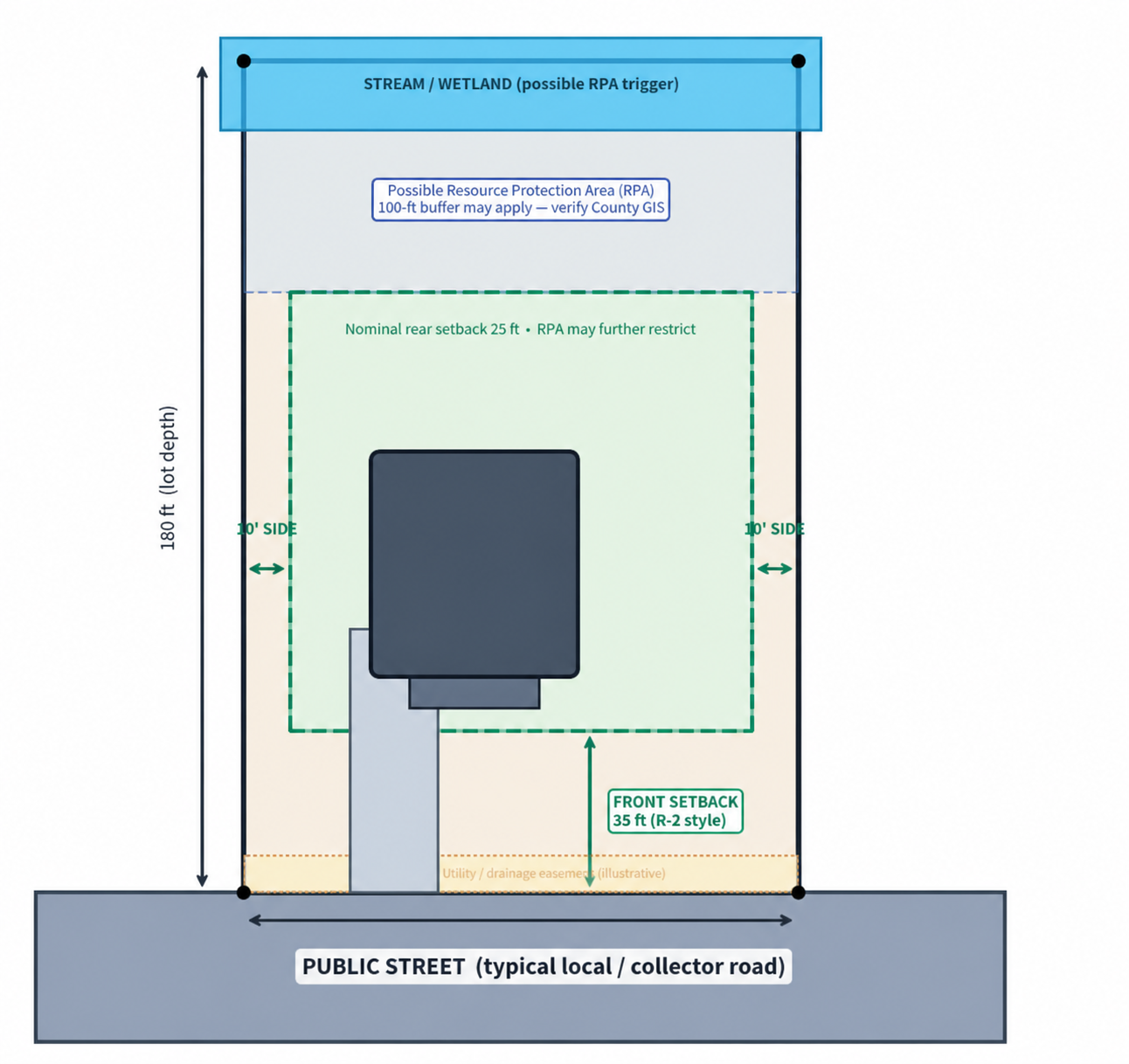

Example Plat

Suburban lot with a possible RPA constraint

Example Prince William County lot showing a proposed house, setbacks, stream or wetland, and a possible Resource Protection Area

Local Peculiarities

Issues that can affect area, cost, and schedule

Resource Protection Areas

Perennial streams and certain wetlands can create 100-foot buffers that restrict disturbance, clearing, grading, and construction.

Public or private utilities

Developed areas often use public service; rural properties may require a soil evaluation, approved septic design, and private well.

County ePortal

Residential permits, plan reviews, comment responses, inspection scheduling, and status tracking flow through the online system.

Grading & stormwater

Clearing and land disturbance can trigger erosion-control, grading, and stormwater requirements that affect cost and schedule.

Overlays & special areas

Airport safety, historic battlefield, environmental, and other planning areas may add design or review requirements.

Road access

New or modified entrances on state-maintained roads can require VDOT approval in addition to County permits.

Pre-Construction Roadmap

Prince William County lot checklist

Complete zoning, survey, environmental, utility, access, and budget due diligence before final design.

01

Confirm ownership and restrictions

Review the deed, title, easements, access rights, and private covenants.

02

Verify zoning in writing

Use County Mapper and Zoning Administration to confirm the parcel and district standards.

03

Commission a current survey

Map boundaries, topography, improvements, utilities, easements, streams, wetlands, and setbacks.

04

Screen RPA and environmental constraints

Review County GIS, flood zones, streams, wetlands, and any need for field delineation.

05

Evaluate utility strategy

Confirm public connections and costs or coordinate septic evaluation, well permits, and other services.

06

Review soils and foundations

Obtain preliminary geotechnical information and coordinate septic feasibility where applicable.

07

Resolve driveway access

Determine whether County, VDOT, private-road, or maintenance requirements apply.

08

Prepare a conceptual site plan

Place the home, drive, utilities, grading, stormwater, and outdoor areas inside the true envelope.

09

Budget site work realistically

Include clearing, grading, erosion controls, utility laterals, driveways, and stormwater measures.

10

Use County-experienced professionals

Coordinate typical ePortal review comments, RPA issues, and agency requirements early.

11

Secure construction financing

Include site work and meaningful contingency for unknown property conditions.

12

Sequence formal approvals

Coordinate zoning, land disturbance, septic or well, building, trade, and inspection requirements.

How the Process Flows

From due diligence through ePortal and inspections

After feasibility, the team prepares architectural and site plans, submits through ePortal, responds to County review comments, obtains approvals, and coordinates construction inspections.

01

Feasibility

Zoning, survey, RPA, access, utilities, and soils

02

Design

Architecture, site plan, engineering, and site budget

03

Approvals

County ePortal, outside agencies, trades, and utilities

04

Construction

Approved work through inspections and occupancy

Ready to explore your Prince William County lot?

Share your address and survey. We’ll discuss the likely envelope, RPA and utility questions, site work, permitting path, and a realistic route to construction.

Request Your Lot Review

This page and example plat provide general educational information, not a survey, zoning determination, environmental delineation, permit approval, or legal opinion. Verify current parcel-specific requirements directly with Prince William County and licensed professionals.
